LIVING LAB N°28

LL28

LIVING LAB N°28

Office building of Pellini, Codogno, Italy

IDENTITY CARD

Building type:
Location:
Year of construction:
Number of occupants:
Energy consuption:
Products interested in:
Products confirmed:
Quantity:

Offices and meeting rooms
Codogno, Italy
2020
20

Pellini's retroreflective shading
Pellini's retroreflective shading

MOTIVATION FOR PRODUCT TESTING

Assessment of retroreflective shading device on indoor environmental quality, complimentary to the results measured within PM&VL2 and PM&VL5.

Product description

Pellini SpA's retroreflective shading device is a solar shading device consisting on a venetian blind comprising retro reflective coating based on silicon dioxide micro beads.

LL28Banner

Building description

2-story building with 200 m² steel covering and insulating panels, 240 m² aluminium and triple glazing facade, 250 m² concrete foundation, 2.5 m² aluminium and triple glazing doors and 25 m² pantograph motorized windows.

Climate

Temperatures ranging from -5°C to 35°C. Frequent sunny days during summer, high moisture and fog during winter.

Internal climate

The building is controlled by cool beams and the only issues seems to have too much dry air on winter.

Renovation plan

The exterior glass façade will be changed with new façade with retroreflective shading being integrated in the glass panels.

Monitoring Plan

Thermal comfort parameters:
IAQ study:
Acoustic study:
Post-occupancy evaluation:
Envelope performance:

Indoor air temperature, relative humidity
CO2, PM2.5, PM10, formaldehyde, TVOC
-
Basic “one-off questionnaire” on the user-satisfaction with the overall indoor environmental quality
Heat flux, surface and ambient temperature

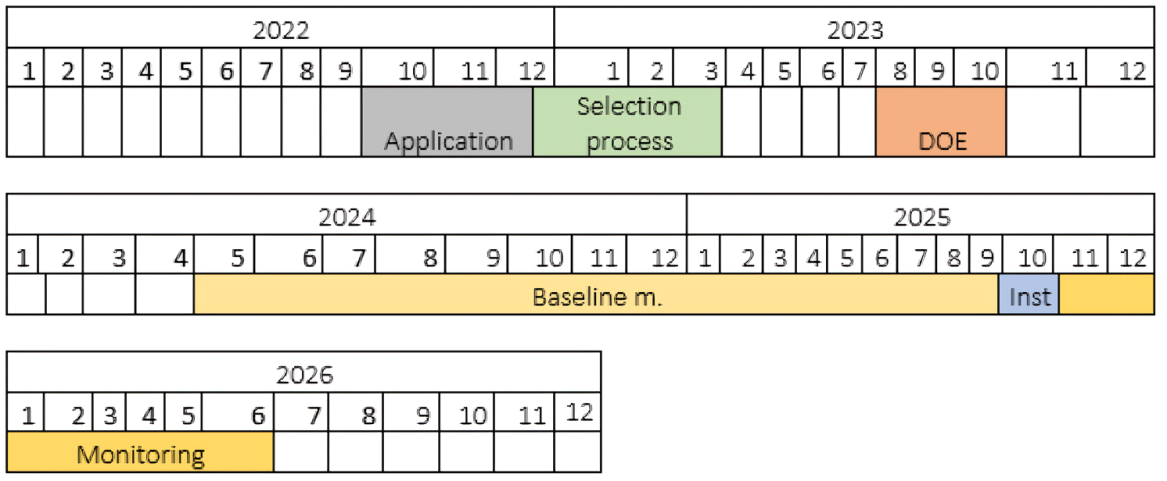

Timeline

Actions

Baseline measurements were performed from May 2024 to October 2025.
Renovation was performed in October 2025.
Monitoring after the renovation is ongoing since November 2025.

Timeline28

LL28_photo1
LL28_photo2

Office building before renovation, May 2024.

LL28_photo3
LL28_photo4

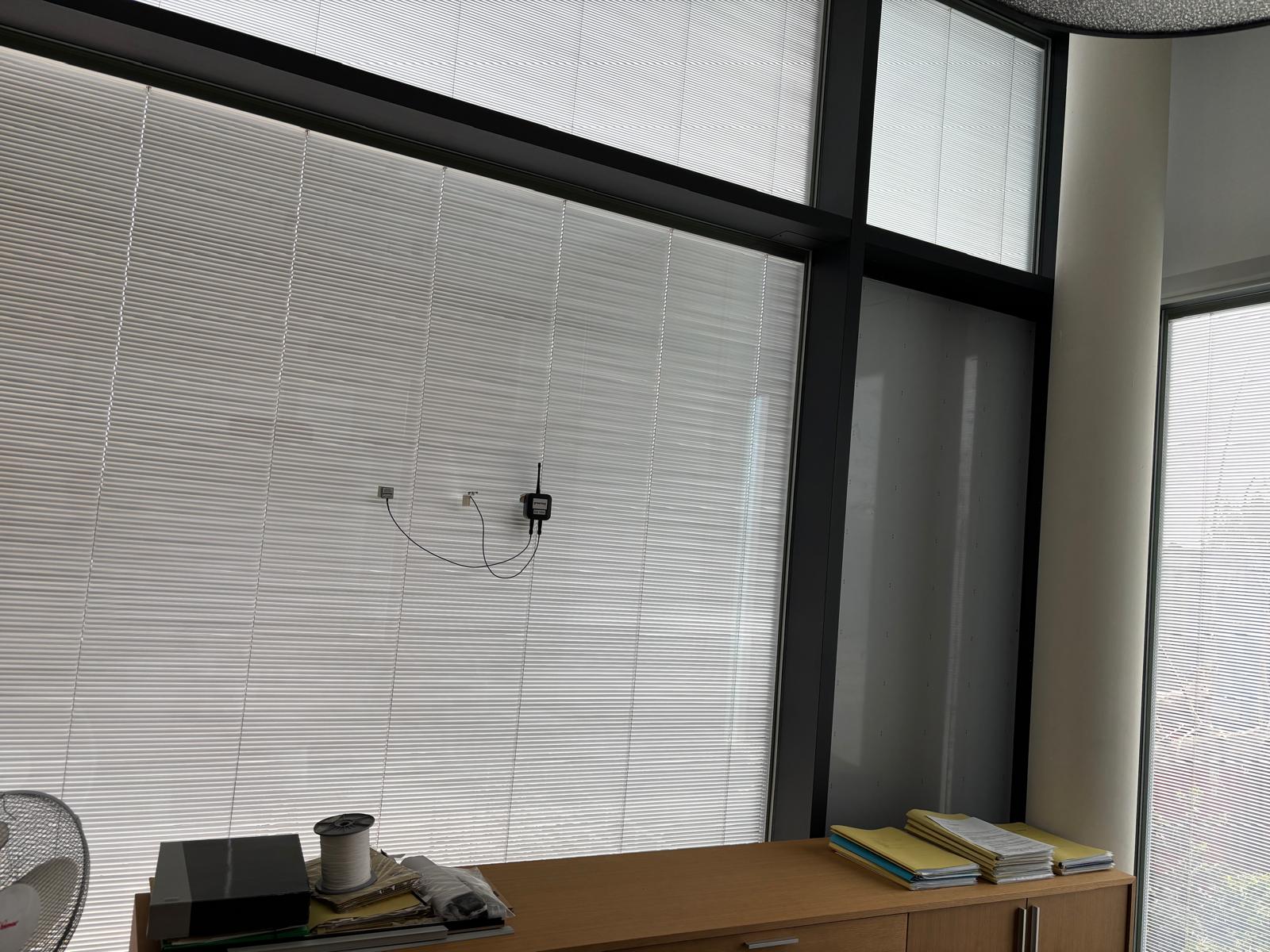

Monitoring units installed in May 2024 and July 2025.

LL28_photo5

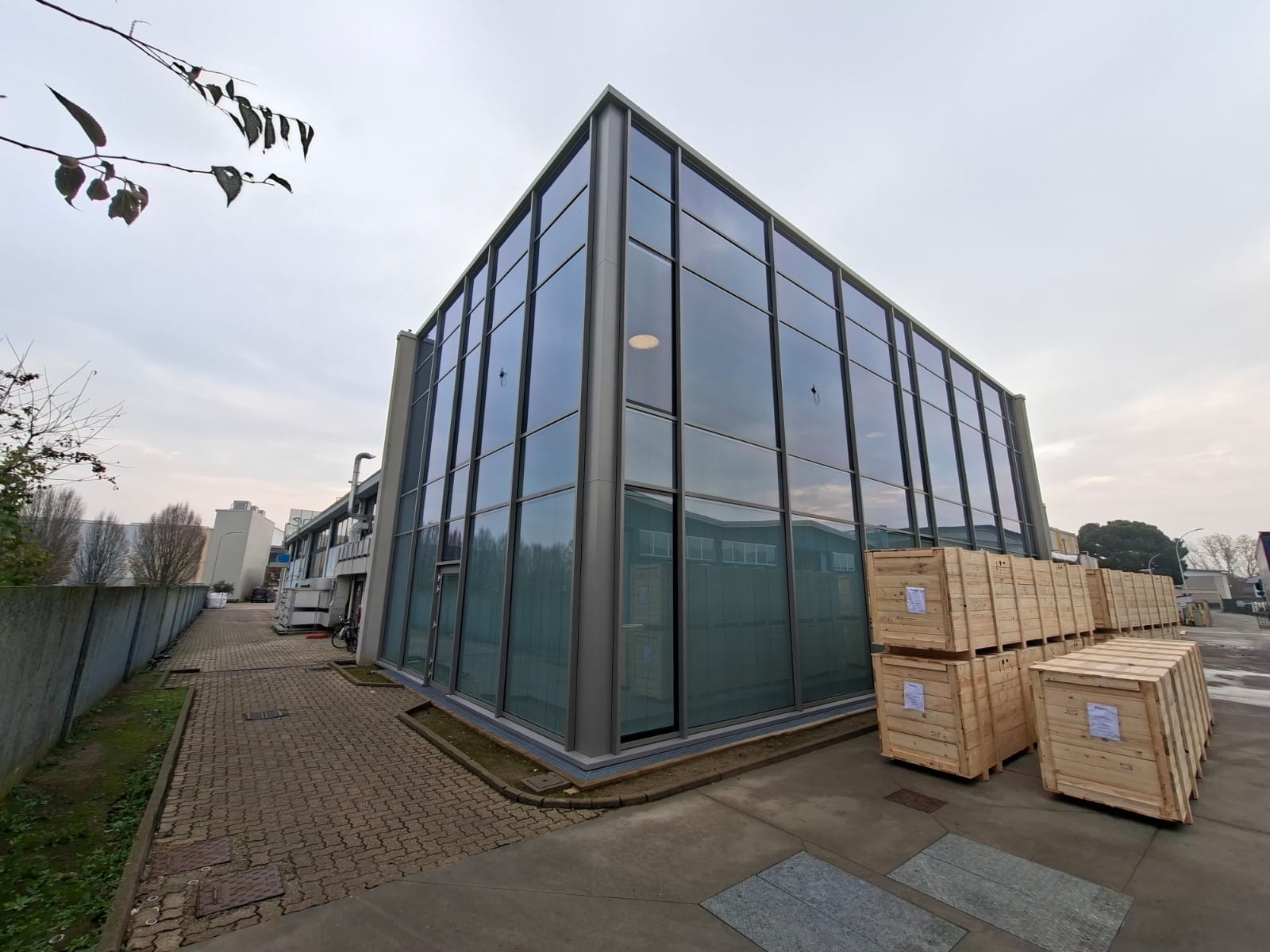

New glass façade installed, December 2025.
